Sloane Street Road Safety Project

In March 2024, Northern Grampians Shire Council received $1,811,779 in funding under the Australian Government's 2023-24 Black Spot Program.

Every year, hundreds of Australians lose their lives or are seriously injured in road crashes. The Black Spot program improves road safety and helps prevent serious injuries and deaths on our roads. Black Spot projects target dangerous road locations where crashes are occurring or are at risk of occurring. The Australian Government provides funding for measures such as traffic signals and roundabouts at Black Spots, reducing the risk of crashes.

There has been a high rate of vehicle accidents along Sloane Street in Stawell with increasing indications that a serious injury could occur. Rather than waiting for someone to be significantly impacted in a road collision, Council applied for Black Spot funding which was granted in March last year to aid with the implementation of several risk mitigation solutions.

Works involve speed reductions, new roundabouts, new center medians, new kerb outstands, improved signage and improved safety for pedestrians and cyclists. The works have been delivered at multiple locations along Sloane Street from Patrick Street all the way through to the Western Highway.

The following eight road safety enhancement projects are being delivered under this funding, with final works under Project Eight to be completed by early March 2025.

Read more by expanding each project below.


Project One - Sloane Street and Patrick Street Intersection Safety Works

Project summary: Works involve installing kerb outstands to improve sight distance at the intersection. Bicycle lanes will be installed, and pedestrian facilities improved.

Project status: Nearing completion

Project update (February 17, 2025): Resealing and line-marking works, along with the installation of street lighting, are scheduled for completion in February.



Project Two - Sloane Street and Maud Street Intersection Safety Works

Project summary: Works involve installing kerb outstands to improve sight distance at the intersection.

Project status (February 17, 2025): Nearing completion

Project update (February 17, 2025): Resealing and line-marking works, along with the installation of street lighting, are all scheduled for completion in February.



Project Three - Sloane Street and Wakeham Street Intersection Safety Works

Project summary: Works involve installing kerb outstands to improve sight distance at the intersection. Bicycle lanes will be installed and pedestrian facilities improved.

Project status (February 17, 2025): Nearing completion

Project update (February 17, 2025): Resealing and line-marking works, along with the installation of street lighting, are all scheduled for completion in February.


Project Four - Sloane Street and Shirreff Street Roundabout

Project summary: Works involve the installation of a new roundabout at the Shirreff Street intersection. This will provide a much safer intersection for all road users. Works also include the installation of median islands at Dawson Street.

Project status (February 17, 2025): Nearing completion

Project update (February 17, 2025): Installation of street lighting is being completed in February.


Round 2.png

Project Five - Sloane Street and Brown Street Intersection Safety Works

Project summary: Works involve installing kerb outstands to improve sight distance at the intersection. Bicycle lanes will be installed and pedestrian facilities improved.

Project status (February 17, 2025): Nearing completion

Project update (February 17, 2025): Resealing and line-marking works, along with the installation of street lighting, are all scheduled for completion in February.


Project Six - Sloane Street and Cooper Street Roundabout

Project summary: Works involve the installation of a new roundabout at the Cooper Street intersection. This will provide a much safer intersection for all road users.

Project status (February 17, 2025): Nearing completion

Project update (February 17, 2025): Installation of street lighting is being completed in February.

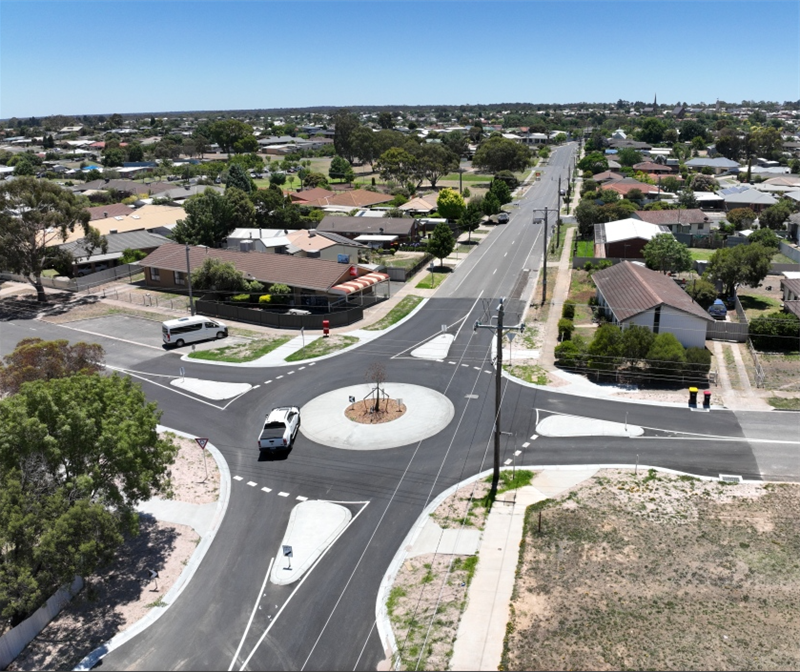

Round 1.png

Project Seven - Construction of Bike Lanes from Cooper Street to the Western Highway

Project summary: Road widening will be undertaken to accommodate for bike lanes on both sides of Sloane Street from the Western Highway to Cooper Street.

Project status (February 17, 2025): Nearing completion

Project update (February 17, 2025): Resealing and line-marking works are being completed in February.

Project Eight - Speed Reduction Along Sloane Street

Project summary: The speed along Sloane Street currently varies from 50km/h to 60km/h. It has been decided that Sloane Street should be made 50km/h from Patrick Street through to Cooper Street. The section of Sloane Street from Cooper Street to the Western Highway will remain at 60km/h.

Project status (February 17, 2025): In progress

Project update (February 17, 2025): Works will begin in late February and be completed by early March.

Project timelines

Inform community on proposed works:

October 2023

Complete detailed design for projects:

December 2023

Construction period:

February 2024 to February 2025

Supporting materials

This project aligns with Council's Rural Road Safety Plan 2021-2025 and Victoria’s Road Safety Strategy 2013-2022 which include critical safety focus areas such as rural road safety, safety around schools, bicycle and pedestrian safety, and safer speeds in urban areas.

Read more:

Rural Road Safety Plan 2021-2025

Victoria’s Road Safety Strategy 2013-2022

Project contact

Phone: 03 5358 8700

Email:nic.murphy@ngshire.vic.gov.au
